Having trouble deciphering Predecessor rules: need help! | Community
Skip to main content
New Participant
November 30, 2022
Solved

Having trouble deciphering Predecessor rules: need help!

  • November 30, 2022
  • 1 reply
  • 561 views

The use case:

The business would like a task to be able to be marked as "In Progress" even if the predecessors are not fully completed, but don't want the task to be able to be completed before the predecessors are complete.

It looks like either Finish-Finish (ff) or Scheduled-Start (sd) should work, but I am still unable to prevent the task from not completing. It's more than likely I am misunderstanding the rules, but I have tried every single predecessor type and cannot prevent the task from completing before its predecessor is complete.

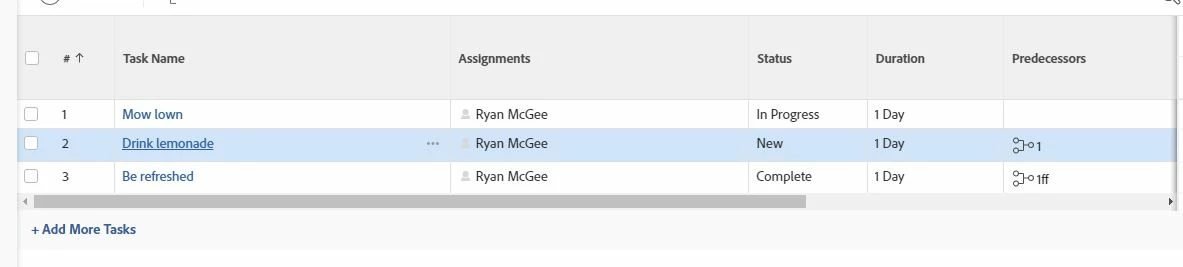

In the case below: I'd like either task 2 or 3 to be able to be moved into In progress, but not able to be completed until Task 1 is marked as complete. What should go in the predecessor columns?

Thanks in advance,

Ryan

This post is no longer active and is closed to new replies. Need help? Start a new post to ask your question.
Best answer by JMitchell44

Hi Ryan,



I think you're looking for ffe - Finish to Finish Enforced. More info here: https://experienceleague.adobe.com/docs/workfront/using/manage-work/tasks/use-task-predecessors/enforced-predecessors.html?lang=en

Using that as the dependency type on tasks 2 and 3 should get you what you're looking for.



-John

1 reply

JMitchell44
JMitchell44Accepted solution
New Participant
December 1, 2022

Hi Ryan,



I think you're looking for ffe - Finish to Finish Enforced. More info here: https://experienceleague.adobe.com/docs/workfront/using/manage-work/tasks/use-task-predecessors/enforced-predecessors.html?lang=en

Using that as the dependency type on tasks 2 and 3 should get you what you're looking for.
