Question

Is there a way for an issue report to show if an issue is late, on time, etc. (tasks have "progress status", projects have "condition", but issues don't)?

  • June 19, 2023
  • 1 reply
  • 634 views

Is there a way for an issue report to show if an issue is late, on time, etc.?  Meaning, if I am looking at the report today and the planned completion date for the issue was yesterday, can there be a column that shows the issue is "late"?  I don't see a "progress status" field option for issues like I see for tasks.  And projects have a "condition" field option that is equivalent to that.  When I choose "condition" for issues, all I get is "going smoothly, concerns, etc." which is tied to the last update.



Does anyone have a workaround that can maybe calculate the issue's progress status/condition (i.e. late, at risk, on time), depending on planned completion date and when the report is seen/run?



Any insight and/or help is greatly appreciated.  Thanks!

This post is no longer active and is closed to new replies. Need help? Start a new post to ask your question.

1 reply

VicSellers
New Participant
June 19, 2023

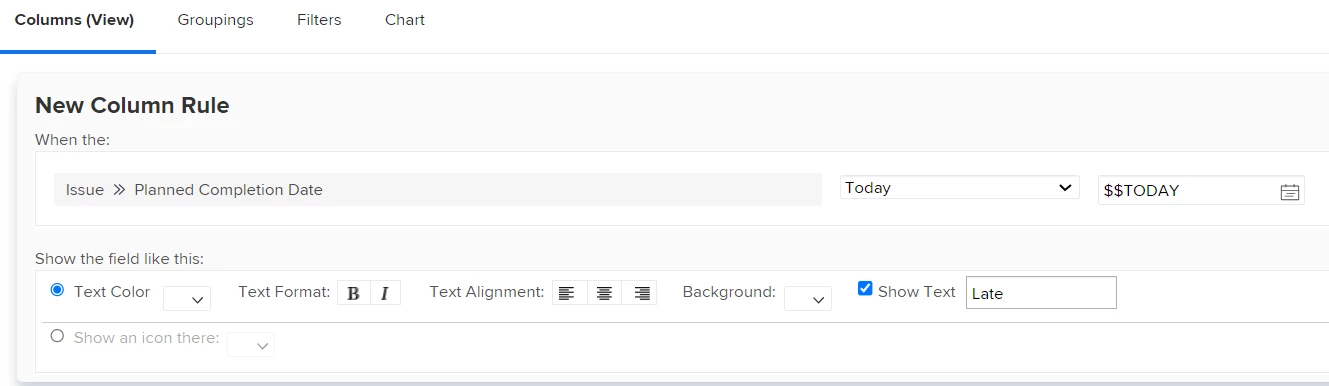

Hi @giselleseoane! What about an Issue Report with a column that uses custom text? To set it up, you could choose Planned Completion Date as the column, then Advanced Options > Add a Rule for this Column and then choose a date range for each set of criteria and enter the custom text / formatting (screenshot below). You could do $$TODAY for Late, $$TODAY+2d for At Risk, etc. (2d standing for days).



Hope this helps!



New Participant
June 21, 2023

Thanks so much for this!!!!  Although it's not perfect to calculate "behind", since status (and % comp) would help determine that, it's still a HUGE win to be able to export the report with issues identified as "late" and "on target".  I can just manually change some of the "on target" to "behind" depending on their status and % comp.



It's too bad we can't create a rule that has more that one truth like:

  • planned start date is < than today; and
  • status is = new

Thanks again!
